How to Calculate Construction Cost Per Square Foot in Pakistan (2025)
August 26, 2025
From Design to Build – Afaq Ahmad Constructions Offers Complete Services
September 1, 2025
Pakistan’s real estate sector is flourishing with a projected growth rate of over 5% annually through 2028. With a housing deficit exceeding 10 million units, building your first home is a dream within reach in cities like Lahore, Islamabad, and Karachi. At Afaq Ahmad Constructions, we’ve guided numerous first-time homeowners through this journey, from 5 Marla plots (PKR 7-12 million) to 10 Marla homes (PKR 16.3-20 million). This blog offers a step-by-step guide to building your first house in Pakistan for 2025, ensuring a smooth, cost-effective, and compliant process.
Why Building Your First House Matters in 2025
Pakistan’s diverse climate—Lahore’s 40°C summers and 600-800 mm monsoons, Karachi’s humidity, and Islamabad’s seasonal shifts—shapes construction needs, as noted in our weather blog. The Pakistan Building Code (PBC) 2021 and Green Building Code 2023 enforce safety and sustainability, while material costs (e.g., cement at PKR 1,060/bag) and labor rates (PKR 450-500/day) have risen by 5-7% in 2025, per our cost and timeline blogs. A well-planned build can save PKR 500,000-1 million and add 10-15% to property value. Let’s dive into the steps.
Step-by-Step Guide to Building Your First House
1. Define Your Budget and Secure Financing
- Step: Establish a realistic budget and explore funding options.
- Details: For a 5 Marla home, budget PKR 7-12 million; for 10 Marla, PKR 13-20 million. Include a 10-15% contingency (PKR 1-3 million), per our cost guide. Options include bank loans (e.g., HBL at 8-10% interest) or personal savings.
- Timeline: 1-2 months.
- Cost: Loan processing fees (PKR 50,000-100,000).
- Tip: Consult a financial advisor and use Afaq Ahmad Constructions’ cost calculator for accuracy.
2. Choose and Purchase the Plot
- Step: Select a plot based on location, size, and legal status.
- Details: Popular areas include DHA Lahore, Bahria Town, and Johar Town. Verify ownership with a property agent (PKR 50,000-100,000) and check LDA/DHA records. A 5 Marla plot costs PKR 50-70 lakh, 10 Marla PKR 1.5-2 crore.
- Timeline: 1-3 months.
- Cost: Plot price + transfer fees (2-3% of value).
- Tip: Avoid disputed land to prevent legal delays, per our approvals blog.
3. Hire Professionals and Create a Design
- Step: Engage an architect and structural engineer.
- Details: Design a single-story 5 Marla (1,000-1,200 sq ft) or double-story 10 Marla (3,500 sq ft) home. Costs: architect (PKR 20,000-50,000), engineer (PKR 30,000-70,000). Use CAD software for precision, per our trends blog.
- Timeline: 1-2 months.
- Cost: PKR 50,000-120,000.
- Tip: Opt for open-plan layouts to save space and costs.
4. Obtain Approvals and Permits
- Step: Secure necessary permissions from local authorities.
- Details: Submit plans to LDA (PKR 38/sq ft scrutiny + 3% TIP tax) or DHA (20 days process). Include environmental clearance for Green Building Code 2023 compliance.
- Timeline: 60-90 days for LDA, 20 days for DHA.
- Cost: PKR 300,000-500,000 (e.g., PKR 42,750 for 1,125 sq ft).
- Tip: Use Afaq Ahmad Constructions to expedite, avoiding fines (PKR 500,000+).
5. Plan Materials and Labor
- Step: Source materials and hire a contractor.
- Details: Use fly ash bricks (PKR 10-15 each), PPRC pipes (PKR 150-200/meter), and standard tiles (PKR 100-200/sq ft). Hire a contractor (PKR 30,000-50,000/month supervision) and labor (PKR 450-500/day), per our bricks and plumbing blogs.
- Timeline: 1-2 weeks pre-construction.
- Cost: Varies; bulk buying saves PKR 200,000-300,000.
- Tip: Store materials under cover to avoid monsoon damage.
6. Execute the Construction Phases
- Step: Follow a structured build schedule.
- Site Preparation (1-2 weeks): Clear land, level soil (PKR 50,000-100,000).
- Foundation (4-6 weeks): Lay RCC (PKR 400-600/sq ft).

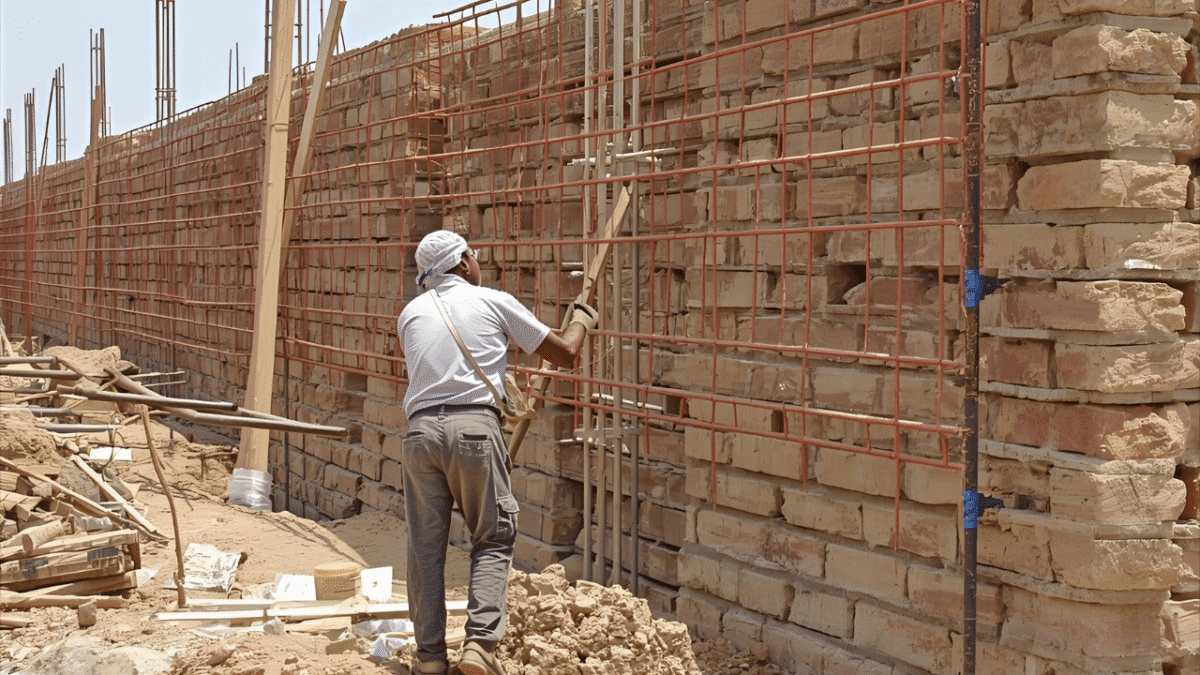

- Grey Structure (12-16 weeks): Erect walls and roof (PKR 900-1,400/sq ft).
- Finishing (8-12 weeks): Install flooring, paint, fixtures (PKR 350-1,100/sq ft).
- Additional Works (4-6 weeks): Plumbing (PKR 300-500/sq ft), electrical (PKR 200-400/sq ft).
- Timeline: 24-40 weeks total, per our timeline blog.
- Cost: PKR 2,800-5,500/sq ft, depending on quality.
- Tip: Monitor progress weekly with a supervisor, per our QA blog.

7. Incorporate Sustainability and Safety Features
- Step: Add eco-friendly and secure elements.
- Details: Install double-glazed windows (PKR 5,000-10,000 each), LED lights (PKR 500-1,000 each), and a basic alarm system (PKR 30,000-50,000). Use heat-resistant tiles (PKR 150-300/sq ft), per our sustainable and security blogs.
- Timeline: Integrate during finishing.
- Cost: PKR 150,000-300,000, saving PKR 20,000-30,000/year.
- Tip: Align with Green Building Code 2023 for future incentives.

8. Conduct Inspections and Finalize
- Step: Inspect and obtain occupancy certificates.
- Details: Check for structural integrity, leaks, and compliance with PBC 2021. Hire an inspector (PKR 20,000-50,000) and submit to LDA/DHA for approval.
- Timeline: 1-2 weeks post-construction.
- Cost: PKR 50,000-100,000.
- Tip: Document with photos for records, per our supervision blog.
9. Move In and Maintain
- Step: Furnish and maintain your home.
- Details: Budget PKR 200,000-500,000 for furniture. Schedule annual checks (PKR 10,000-20,000) for plumbing and roofing, per our renovation blog.
- Timeline: Ongoing post-occupancy.
- Cost: Varies; maintenance saves PKR 50,000-100,000/year.
- Tip: Use a maintenance log to track repairs.

Estimated Costs and Timelines
- 5 Marla (1,125 sq ft):
- Cost: PKR 7-12 million (PKR 2,800-4,000/sq ft).
- Timeline: 24-28 weeks.
- 10 Marla (2,250 sq ft):
- Cost: PKR 13-20 million (PKR 3,000-4,500/sq ft).
- Timeline: 28-32 weeks.
- 1 Kanal (4,500 sq ft):
- Cost: PKR 26-50 million (PKR 3,500-5,500/sq ft).
- Timeline: 32-40 weeks.
- Regional Variation: Lahore (PKR 4,000-5,500/sq ft), Islamabad (PKR 3,500-4,800/sq ft), Karachi (PKR 3,800-5,000/sq ft).
Challenges and Solutions in 2025
Challenges
- Inflation: Material costs may rise 5-10% mid-year, adding PKR 500,000-1 million.
- Weather Delays: Monsoons (July-August) add 2-4 weeks, per our weather blog.
- Labor Shortages: Skilled workers delay progress by 1-2 weeks.
- Approval Delays: Bureaucracy extends timelines by 2-4 weeks.
Solutions
- Budget Buffer: Allocate 10-15% (PKR 1-5 million), per our cost guide.
- Weather Planning: Schedule indoor work during rains, saving PKR 200,000-400,000.
- Labor Training: Partner with Afaq Ahmad Constructions for skilled crews.
- Expedited Approvals: Use our network to reduce approval time.
2025 Market Context
- Demand: High in Lahore Smart City, DHA, and Bahria Town for first-time buyers.
- Trends: Affordable, sustainable designs dominate, per our sustainable guide.
- Costs: Inflation and labor shortages challenge budgets.
- Solution: Trust Afaq Ahmad Constructions for end-to-end support.
Visualizing Your First Home
Imagine a 5 Marla home in Johar Town with efficient bricks (our villa image), a 10 Marla house in Bahria Town with smart lighting (our bungalow image), and a 1 Kanal property in DHA Lahore with lush landscaping (our roofing image). Afaq Ahmad Constructions turns your vision into reality.

The Role of Afaq Ahmad Constructions
At Afaq Ahmad Constructions, we guide your first build:
- Expert Planning: We design and budget your home.
- Quality Assurance: We meet PBC 2021 standards.
- Support: We manage timelines, approvals, and maintenance.
Visit https://afaqahmadconstructions.com/ to start your journey today!
Conclusion
Building your first house in Pakistan in 2025 involves defining a budget, choosing a plot, hiring professionals, obtaining approvals, planning materials, executing phases, adding sustainability, inspecting, and maintaining. Costs range from PKR 7-50 million depending on size (5 Marla to 1 Kanal), with timelines of 24-40 weeks. Strategic planning with Afaq Ahmad Constructions ensures compliance and savings of PKR 500,000-1 million. Contact us now to begin your dream home!
